Oracle Primavera Cloud (OPC) Activities and Scope – The Basics

When creating a schedule in Oracle Primavera Cloud (OPC), you should consider using the Scope App in conjunction with the Schedule App. With the Scope app, you can create scope items and choose whether to connect them to activities in the schedule, depending on your project requirements. Scope items are the materials or products needed to complete a project.

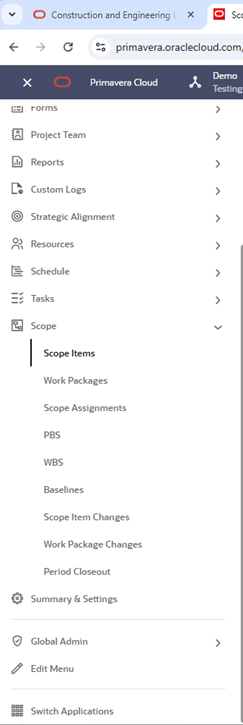

OPC Activities and Scope - The Basics - Image 1

While in the Scope App, you can create scope items in the Scope Items window.

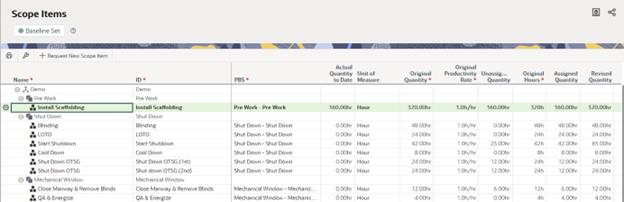

OPC Activities and Scope - The Basics - Image 2

Scope Items can be assigned to work packages and activities in the Scope Assignments window. Work packages are used to track and manage the installation of scope assignments. You can specify the Progress Measure for a Work Package, which enables you to set how progress is measured against scope assignment in work packages.

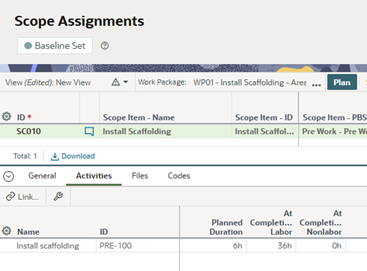

OPC Activities and Scope - The Basics - Image 3

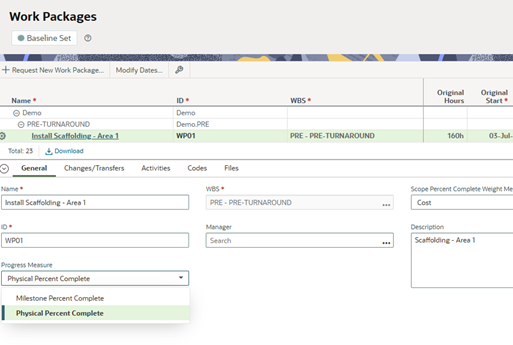

OPC Activities and Scope - The Basics - Image 4

OPC can be used to manage your schedule, and to manage scope assignments. You can link your activities to scope assignments and work packages.

When entering updates, if work packages or their scope assignments are associated with activities, this is handled through the activity updates (remember to set your project baseline before progress is entered).

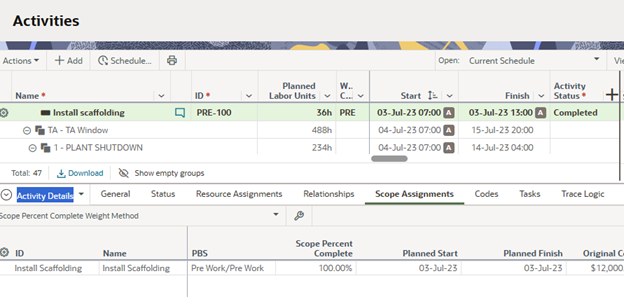

OPC Activities and Scope - The Basics - Image 5

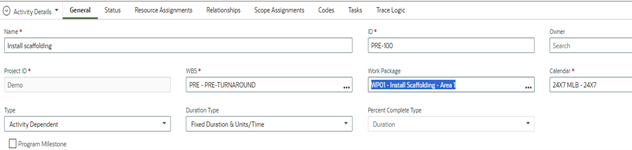

OPC Activities and Scope - The Basics - Image 6

One thing to keep in mind is that schedule costs and scope costs are calculated separately. Linking a work package or scope assignment with an activity won't link those costs together. While each activity can have multiple scope assignments linked to it, an individual scope assignment can only be linked to a single activity.

You can set a default scope percent complete method by configuring it in the project settings.

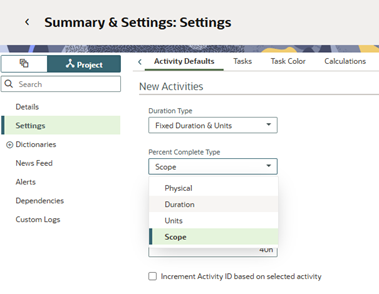

OPC Activities and Scope - The Basics - Image 7

OPC offers Schedule and Scope App functionality to help monitor progress more efficiently. Link work packages to activities when you want to manage work package dates using activity dates. Link activities to scope assignments when you want to manage scope assignment dates using activity dates.

Consider what you are tracking, how you will be handling status updates, and what kind of reporting you require. Once you understand all these things, you will be able to utilize OPC’s functionality to your advantage.
No video selected.

About the Author

Mary Lynn Backstrom, PMP, PMI-SP, PMI-BA – Implementation Specialist

Mary Lynn spent many years filling a variety of project controls duties such as planning, scheduling, analyzing, training and continuous improvement in the Aerospace Industry. Since joining Emerald in 2008, she has been a tremendous asset to the Emerald team. She has worked as a lead scheduler for turnarounds, led sessions for review and troubleshooting of scheduling and reporting, created and given custom training courses for clients, and is a sought after Primavera P6 trainer.

Mary Lynn enjoys some very diverse spare time activities. Along with a variety of outdoor activities such as gardening, she also enjoys making life size lawn ornaments for special holidays like Christmas. Mary Lynn is known for her participation in the community as well. You may have seen her walking in fundraisers in Edmonton and Calgary for the Cancer Society.

Leave a comment

Please login to leave a comment.
