Skip to main content

Withholding the Current Period from P6-Reporter with an Integrated P6

Preventing Current Period Actuals from Bleeding into the Previous Period

Many of our clients use Primavera P6 as one part of an integrated solution involving other systems. One common scenario is to bring labour actuals from a timesheet system or cost actuals from an accounting system into P6. This allows the projects team to see all of the project data in the tool they are familiar with and orients them around a project-major axis.

In such a scenario, we will often build an integration to bring the actuals in once per day during a nightly integration. But this can cause issues when P6 is also used for enterprise reporting. When using P6 and P6-Reporter (previously EP-datawarehouse) for financial period reporting, there is always a window after the end of the previous period and before the data for that period is brought into P6 and made report-ready. Having the actuals automatically brought in to P6 inside that window is counter-productive, as it would cause current period actuals to be reported in the previous period, effectively over-stating the actuals for that period. At the same time, the project team is still going to want to have access to the information about all of the relevant actuals to date, and they are going to want to see that information in P6.

We devised a solution for this problem for one of our clients by creating a "holding bucket" for current period actuals that are pulled in from the accounting system before the previous period has been snapshotted. We implemented this as activity-level UDFs (user-defined fields) in P6 to hold the current period actual cost, current period actual labor cost, and current period actual labor units.

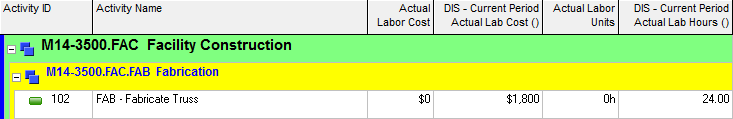

Current Period Actuals UDFs in Primavera P6

Each night, when our actual integration runs, it checks the P6-Reporter database to see if the previous period has been snapshotted. If it has, the integration populates the current period actuals into the real actual fields in P6. If the previous period has not yet been snapshotted, the integration populates the current period actuals into the holding bucket UDFs instead.

By keeping the current period actuals out of the real actuals fields until the previous period's snapshot has been taken, we ensure that the reporting data snapshot for the previous period does not include any unwanted actuals from the current period. By keeping that information in the holding bucket UDFs, we ensure that it is still available to project managers who need to see it.
